Azure Boards practical example - Sprint Capacity
After preparing as best as we could our Sprint Planning to keep it short and efficient, let’s see now how we can get a realistic Team capacity
for the Sprint.
Disclaimer: These articles are very personal so feel free to disagree. I am hoping to provide a interesting feedback to help you make your own decisions.
Sprint Capacity preparation
To calculate the Sprint capacity
, Azure Boards
will mainly try to count the number of Working days
in a Sprint, and will multiply it by the daily capacity
in Hours
of the Team members
.
So let’s first see how to configure the Working days
of a Sprint.
Configure the Sprint Working days
First of all, you have to set the Team Working Days if not already done. (Note that by default only Saturday
and Sunday
are not considered as working days).

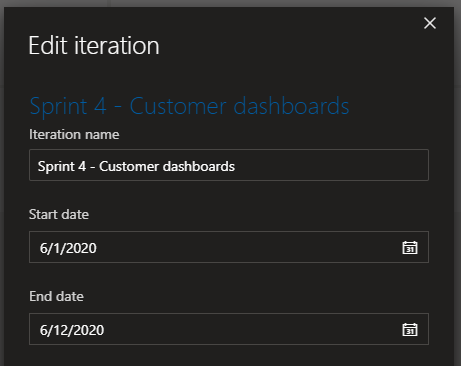

Then obviously, we need to set the Sprint Dates

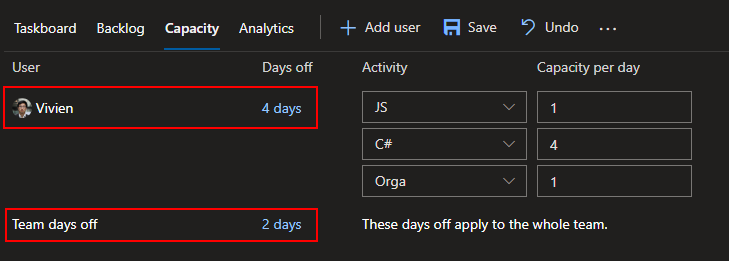

Finally, we need to make sure that all Team members are defined in the Sprint capacity, and then define the Team days off
(if any).
From there you can already check the calculated Sprint working days
If possible, don’t forget also to specify individual team members days off (also if any of course).
Alright, so far we manipulated days
, but most of Azure Boards
features are expressed in hours
, so let’s see how to convert these days
into hours
.
Personal feedback: Use 1 day = 6 hours to convert your estimates
As Azure DevOps
only use hours for estimates, we use 6 hours
when we want to describe an estimate of a full day task
and 3 hours
for a half a day task
.
1 day
corresponding to 6 hours
is a completely arbitrary value and was chosen as the most fitting value for us, because it enables us to still get meaningful estimates while not micro tracking
every unplanned events (pair programming, review, questions, discussions etc. etc.)
Define Sprint global capacity and capacity by activity and member
Given the estimates scale described before, let’s first configure the Team members capacity, specifying a capacity of 6
hours (for a full day of work) per team member.

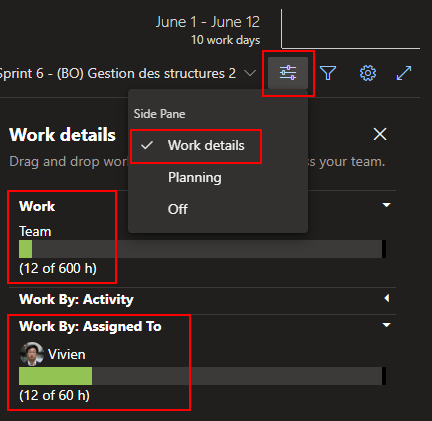

With this, you should be able to see the Sprint global capacity
as well as the individual member capacity
from selecting Work details
in the View options
:
In the picture above, the Team overall capacity
is 600 hours
(meaning 10 people in the team for a 10 days Sprint), and 12 hours
of Remaining Work
are already defined in the Sprint.
For the Team member Vivien
, he has a capacity of 60 hours
, and is already assigned to some Tasks
, for a overall of 12 hours
of Remaining Work
to do during the Sprint.
You can typically see this kind of view before or at the beginning of the
Sprint Planning
That’s a good start and could already be sufficiant for your context, but I found myself using very often another feature: The Task Activity
field.
This field enables us to categorize tasks
by affinity:
For instance, I often see teams composed of JavaScript/TypeScript
developers and C#
developers. So instead of just seeing 600 hours of team capacity

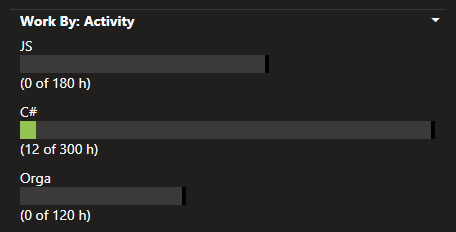

, would not it be better to get a little bit more detailed view and be able to see 180 hours of JavaScript/TypeScript capacity
, 300 hours of C# capacity
and 120 hours of organization
?
Note that by default, Activity field contains only
Deployment
,Design
,Development
,Documentation
,Requirements
andTesting
values. If you want to use custom values as shown above, you need to customize theActivity
field.
If you don’t have access to the work item customization, you can still agree on a defined mapping inside the team such asDesign
forJavaScript
developers,Development
forC#
developers,Requirement
for the team members related to organization, etc.

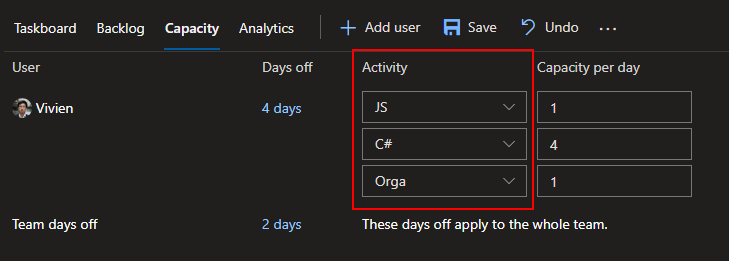

For this, you will need to come back once again to the Sprint Capacity tab and configure this time the Activity
of the Team member (and add multiple activities if the Team members needs to perform different type of tasks)
Wrap up
That’s all for this second part about Sprint capacity
preparation with Azure DevOps.
I hope this article could give you an overview of capacity management
with Azure DevOps. Of course, this article is heavily related to the next article which will talk about getting a realistic scope of work
for a Sprint. (I will try to write it as soon as possible not to let the suspens fade away haha)
Feel free to show your disagreements or any other opinion in the comments or in reply to my Twitter @vivienfabing. May the code be with you!
